Tanjung Carat Port
Connecting South Sumatra's industries to global trade networks through world-class port infrastructure.
Project Value
1.2B USD
Total estimated value of all stages of the project
Development Stages
5+ Years
Development of the port divided by 3 consecutive stages
Land Concession
50+ Years
Duration of the land concession agreement (KSP) of the port
Total Area
230 ha
Total area of the port and land facilities
Project Evolution
Tracking strategic growth and infrastructure milestones from conception to full operation.
Milestone #1 • September 2021 • COMPLETED
Designation as National Strategic Project (PSN)
The New Palembang Port at Tanjung Carat was officially designated as a National Strategic Project in accordance with Regulation of the Coordinating Minister for Economic Affairs of the Republic of Indonesia No. 7 of 2021 concerning the Amendment to the List of National Strategic Projects.
Milestone #2 • July 2022 • COMPLETED
Feasibility Studies
In-depth analysis of technical, economic, and operational viability to ensure long-term sustainability and strategic alignment for the port's infrastructure.
Milestone #3 • August 2022 • COMPLETED
Port Location Determination (Penlok)
Decree of the Minister of Transportation of the Republic of Indonesia No. KM 143 Year 2022.
Milestone #4 • August 2023 • COMPLETED
Port Master Plan (RIP)
Decree of the Minister of Transportation of the Republic of Indonesia No. 83 Year 2023.
Milestone #5 • July 2024 • COMPLETED
Environmental Impact Analysis (AMDAL)
Decree of the Minister of Environment and Forestry of the Republic of Indonesia No. 757 Year 2024.
Milestone #6 • September 2025 • COMPLETED
Reaffirmation as National Strategic Project (PSN)
The Tanjung Carat Port project was reaffirmed as a National Strategic Project (PSN) by the Coordinating Ministry for Economic Affairs of the Republic of Indonesia, strengthening its status as a national priority and accelerating its development process.
Milestone #7 • September 2025 • COMPLETED
Memorandum of Understanding (MoU)
A Memorandum of Understanding between PT Pelabuhan Indonesia (Persero), PT Samudera Pasai Indonesia, and PT Sumsel Energi Gemilang (Perseroda) was signed on September 18, 2025.
Milestone #8 • September 2025 • COMPLETED
Land Utilization Scheme
Between the South Sumatra Provincial Government, the Ministry of Transportation, the High Prosecutor’s Office, KSOP, BPKP, the Regional Office of ATR/BPN, and the Banyuasin Land Office to implement the State-Owned Asset Utilization Cooperation Scheme (KSP BMN) for the development of Tanjung Carat Port.
Milestone #9 • October 2025 • COMPLETED
Handover of the Port Land
Official handover of the Port's Land Certificate from the Governor of South Sumatera to the Minister of Transportation of the Republic of Indonesia was carried out on October 31st 2025.
Milestone #10 • March 2026 • COMPLETED
Signing of Head of Agreement
Between PT Pelabuhan Indonesia (Persero), PT Samudera Pasai Indonesia, and PT Sumsel Energi Gemilang (Perseroda).
Milestone #11 • April 2026 (Today) • COMPLETED
Project Launching
Official project launching and handover of land facilities (Mosaic 6) as well as supporting areas (Mosaic 5).
Milestone #12 • IN PROGRESS
JV Initiator Agreement
Related to the project financing scheme and preliminary shareholder agreement for the establishment of the port operating entity (BUP), covering:
(1) agreement on the equity and loan composition percentages of each consortium member.
(2) consortium members’ loan agreements with banks and investors.
(3) the allocation of rights and obligations among consortium members.
Milestone #13 • IN PROGRESS
Establishment of BUP (Port Business Entity)
Following the Consortium Agreement, the consortium members establish a Special Purpose Vehicle (SPV) to be named PT Pelabuhan Samudera Tanjung Carat, which will be responsible for managing the construction and operation of the port.
Milestone #14 • IN PROGRESS
Signing of State-Owned Asset Utilization (KSP) Agreement
In accordance with the Decree of the Minister of Finance of the Republic of Indonesia Number 361/KM.6/2024, the Special Purpose Vehicle (BUP) will submit a KSP proposal to the Ministry of Transportation for a utilization partnership with a duration of 50+ years.
Milestone #15 • Completion Target Q4 2025 • IN PROGRESS
Groundbreaking of the Port Construction
Upon signing the KSP agreement and reaching financial close, the BUP will appoint a contractor and initiate port construction.

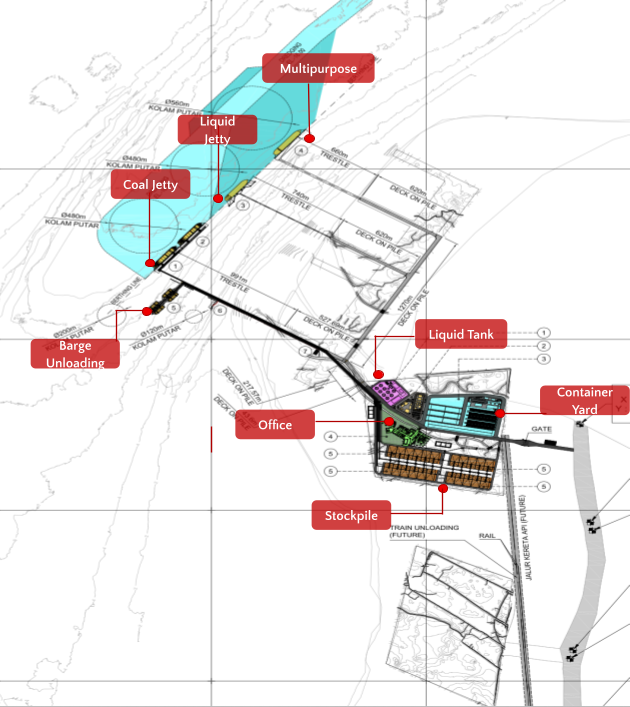

World-Class Services
Dry Bulk
100M Ton
Specialized conveyors and storage for coal, minerals, and commodities.
Liquid Bulk
1450M Ton
Pipeline integration and advanced storage farms for energy sectors.
Multi Purpose
250K TEUs
Automated STS cranes and digital management for elite TEU efficiency.
Latest Updates
Architecting the
Maritime Silk Road
Join the consortium of world-class leaders shaping the strategic hub of South Sumatera. Connect with our dedicated project office today.
